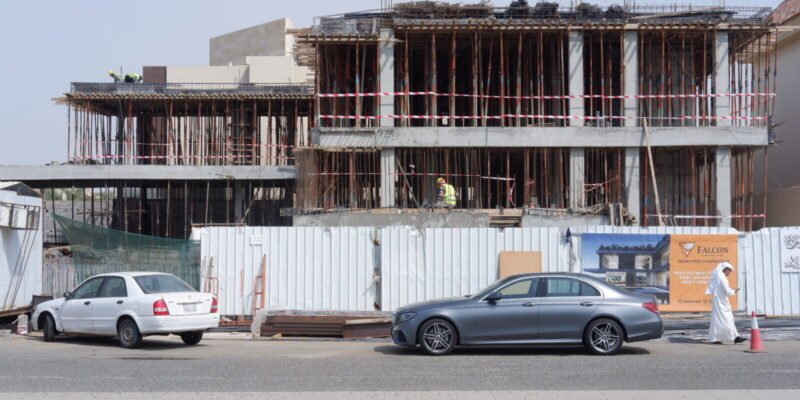

فيلا تحت الإنشاء في جدة تُظهر مرحلة الهيكل الإنشائي

Stages of Building a Villa in Jeddah: A Complete Guide

Building a luxury villa in Jeddah typically takes about 14 months for a villa of 500–1,000 m² built-up area and about 16 months for 1,001–1,600 m², plus about 3 months for design and permitting. In short, the process runs through seven stages: design and permitting, site preparation, foundations, structural frame, rough works, finishing, and final testing and handover.

Many villa owners enter a construction project without knowing what to expect at each stage. As a result, this ambiguity leads to misaligned expectations, friction with the contractor, and sometimes costly decisions made from uncertainty.

At Falcon Construction, we believe an informed client is a satisfied client. Here is a complete guide to the stages of villa construction in Jeddah.

If you are still working out the budget side, our guide to villa construction costs in Jeddah breaks down the numbers before you commit to a design.

Stage 1: Design and Permitting

Before any work begins on site, the design must be completed and official approvals obtained. This stage includes:

Expected duration: about 3 months, depending on project size and complexity. The soil study and the building permit are handled by the engineering office that issues the permit; Falcon can follow up on the permit on the client’s behalf if requested.

Stage 2: Site Preparation and Excavation

Next, the team prepares the plot for construction:

  • Setting out the building boundaries and establishing levels
  • Excavation and backfill according to drawings
  • Removal of surplus soil from site
  • Formwork preparation for foundations

Stage 3: Foundations

Foundations are the first critical structural element — and no compromise is acceptable here. The foundation type is set in the structural design, based on the soil study that the engineering office issuing the permit carries out through an accredited laboratory. Then, Falcon builds the foundations to that design.

  • Pouring of plain and reinforced concrete
  • Installation of reinforcement steel per structural specifications
  • Concrete compression testing

Stage 4: Structural Frame

This phase involves construction of columns, beams, and slabs for each floor from ground level up to the roof.

Expected duration: 3 to 8 months depending on number of floors and design complexity.

Stage 5: Internal Construction — Rough Works

Then, the walls go up and the services run inside them:

  • Construction of internal and external walls
  • Thermal and waterproofing insulation
  • Running pipes and electrical conduits inside walls
  • Plastering and render works

Stage 6: Finishing Works

Next come the finishes you will see and use every day:

  • Installation of floor finishes — marble, stone, ceramic
  • Installation of doors and windows
  • Interior painting and decorative finishes
  • Kitchen and built-in wardrobes installation
  • Final electrical works — switches, lighting, distribution boards
  • Final plumbing works — basins, fixtures, sanitary ware

Stage 7: Testing and Handover

Finally, before handover, Falcon conducts comprehensive testing of all systems: electrical, plumbing, HVAC, fire alarm and suppression. This is followed by a joint inspection walk-through with the client before the completion certificate is issued.

How Long Does the Whole Build Take?

For a luxury villa in Jeddah, expect about 14 months of construction for 500–1,000 m² of built-up area and about 16 months for 1,001–1,600 m². Add about 3 months before that for design and permitting. These durations are indicative and depend on the design and on how quickly the finishes are chosen.

That range moves with the specification level. A villa with a basement, pool, extensive landscaping, or full smart home integration sits at the upper end. However, delays most often come from three sources: late client decisions on finishes, design changes after structural work has started, and material lead times on imported items.

Therefore, the single most effective way to protect your timeline is to finalise finishing selections before the structural frame is complete. Every decision deferred past that point has a compounding effect on the schedule.

Villa Construction Process: Step by Step

Falcon’s villa construction process runs through seven stages, from design and permitting to final handover:

  1. Design and Permitting

    First, complete the architectural and structural drawings, design the MEP systems (mechanical, electrical, plumbing), obtain the building permit from Jeddah Municipality (Amanah), and hold a design review with the supervising engineer. Expected duration: about 3 months depending on project size and complexity. The soil study and permit are handled by the engineering office that issues the permit.

  2. Site Preparation and Excavation

    Next, set out the building boundaries and establish levels, excavate and backfill according to the drawings, remove surplus soil from the site, and prepare formwork for the foundations.

  3. Foundations

    Then, pour plain and reinforced concrete, install reinforcement steel per the structural specifications, and carry out concrete compression testing. The foundation type follows the structural design, which is based on the soil study carried out by the engineering office that issues the permit.

  4. Structural Frame

    After that, construct the columns, beams, and slabs for each floor from ground level up to the roof. Expected duration: 3 to 8 months depending on the number of floors and design complexity.

  5. Internal Construction — Rough Works

    Next, build the internal and external walls, apply thermal and waterproofing insulation, run pipes and electrical conduits inside the walls, and complete plastering and render works.

  6. Finishing Works

    Then, install floor finishes (marble, stone, ceramic), doors and windows, complete interior painting and decorative finishes, install the kitchen and built-in wardrobes, and finish the electrical (switches, lighting, distribution boards) and plumbing works (basins, fixtures, sanitary ware).

  7. Testing and Handover

    Finally, Falcon conducts comprehensive testing of all systems — electrical, plumbing, HVAC, fire alarm and suppression — followed by a joint inspection walk-through with the client before the completion certificate is issued.

Frequently Asked Questions

How long does it take to build a villa in Jeddah?

For a luxury villa in Jeddah, expect about 14 months of construction for 500–1,000 m² of built-up area and about 16 months for 1,001–1,600 m², plus about 3 months beforehand for design and permitting. These durations are indicative.

What causes delays in villa construction timelines?

Delays most often come from three sources: late client decisions on finishes, design changes after construction has started, and specification upgrades mid-build. Therefore, the single most effective way to protect the timeline is to finalize finishing selections before the structural frame is complete.

What are the main stages of building a villa?

Villa construction moves through seven stages: design and permitting, site preparation and excavation, foundations, structural frame, internal rough works, finishing works, and testing and handover — each stage depends on the one before it being fully complete.

What increases villa construction time in Jeddah?

Specification level has the biggest effect — a villa with a basement, pool, extensive landscaping, or full smart home integration sits at the upper end of the timeline range, since these elements add coordination and construction complexity across multiple stages.

Are you in the planning stage for your villa? Contact the Falcon team for a detailed project timeline tailored to your specific scope.

Curious what a Falcon-built villa looks like? See our luxury villa and residential construction service.

Luxury villa construction project in Jeddah by Falcon Construction

How Much Does It Cost to Build a Luxury Villa in Jeddah?

Luxury villa construction in Jeddah costs SAR 2,500–6,000 per square meter of built-up area, depending on specification level. The main cost drivers are structural complexity (a 15–25% premium for basements or pools), MEP systems (20–30% of total cost), and finishing choices. In addition, Falcon provides transparent, itemized quotations before any project commitment.

Last updated: 3 October 2026. All figures on this page are indicative ranges for Jeddah, reviewed every quarter. Your final price depends on design, site and specification, and is confirmed only in a written, itemised quotation.

One of the most common questions we receive at Falcon Construction is: “How much does it cost to build a luxury villa in Jeddah?” It is a fair question. For that reason, it deserves an honest, detailed answer rather than a vague estimate.

In fact, construction cost is not a single number. Instead, it is the result of dozens of decisions made before a single brick is laid. For this reason, this article breaks down the real cost components so you can plan with confidence.

Cost Per Square Meter: The Starting Point

In Jeddah, luxury villa construction typically ranges between SAR 2,500 and SAR 6,000 per square meter of built-up area, depending on specification level:

Specification levelSAR per m² (built-up area)What it typically includes
Standard ResidentialSAR 1,800 – 2,500basic finishes, standard MEP, no premium materials
Mid-Range LuxurySAR 2,500 – 4,000imported tiles, engineered systems, quality finishes
High-End LuxurySAR 4,000 – 6,000premium marble, smart home integration, custom millwork
Ultra-Premium / CustomSAR 6,000+bespoke design collaboration, architectural statement pieces

The Standard Residential tier (SAR 1,800–2,500 per m²) is shown for comparison only; the luxury range quoted above starts at SAR 2,500.

What Drives the Cost Up?

1. Structural Complexity

A villa with a basement, swimming pool, and multiple cantilevers requires significantly more structural engineering than a simple two-storey box. As a result, expect a 15–25% premium on structure costs for complex designs.

2. MEP Systems

Mechanical, electrical, and plumbing systems can account for 20–30% of total construction cost. For example, a villa with full HVAC zoning, smart electrical panels, solar integration, and central filtration will cost considerably more than one with standard installations.

3. Finishing Level

Finishes are often where the greatest variance occurs. For instance, Italian marble vs local stone, custom cabinetry vs off-the-shelf, automated lighting vs standard switches — each choice compounds into a significant cost difference.

4. Contractor Quality and Supervision

A lower quote is rarely a better deal. This is because contractors who win on price often recover margin through shortcuts, change orders, and quality compromises. In contrast, a well-managed contractor with in-house engineering costs more upfront and saves considerably more long-term.

Hidden Costs to Budget For

  • Municipal and authority fees: SAR 30,000 – 150,000 depending on villa size and location
  • Architectural and engineering design fees
  • Dewatering, if groundwater is found on site: usually priced separately after excavation starts
  • Landscaping and external works: SAR 50,000 – 800,000
  • Furniture and loose items: typically 20–30% of construction cost, budget separately

How Long Does It Take to Build a Villa in Jeddah?

Construction time depends mainly on the built-up area. From the start of construction to handover, Falcon’s typical timelines are:

Villa built-up areaTypical build time (start to handover)
500 – 1,000 m²About 14 months
1,001 – 1,600 m²About 16 months

These are indicative timelines, reviewed every quarter, and they stay flexible depending on the client and the design.

How Long Do Design and Permits Take?

Allow about 3 months for design, drawings and permits. This does not include:

  • extra time if you choose to work with a specialised architectural design office, or
  • interior work.

These timings are flexible and depend on the client’s decisions.

The Falcon Approach to Budgeting

At Falcon Construction, we provide transparent, itemized quotations before any project commitment. In addition, we work with structured bills of quantities so that you know exactly what you are paying for, and why. Also, our in-house engineering capability means structural, MEP, and finishing coordination happens under one roof — reducing change orders and protecting your budget from surprises.

Once your budget is set, the next question is what actually happens on site — see our full breakdown of the villa construction process from permit to handover.

Frequently Asked Questions

How much does it cost to build a luxury villa in Jeddah?

Luxury villa construction in Jeddah typically costs SAR 2,500–6,000 per square meter of built-up area, depending on specification level — from mid-range luxury finishes up to ultra-premium, custom architectural work. The final cost depends on structural complexity, MEP systems, and finishing choices.

What drives villa construction costs up the most?

Four factors drive costs the most: structural complexity (a 15–25% premium for basements, pools, or cantilevers), MEP systems (20–30% of total cost), finishing level (marble, custom cabinetry, automated lighting), and contractor quality — cutting corners on supervision often costs more long-term through change orders.

What hidden costs should I budget for beyond construction?

Beyond the build itself, budget for municipal and authority fees (SAR 30,000–150,000), landscaping and external works (SAR 50,000–800,000), dewatering if groundwater is found on site (usually priced separately after excavation starts), and furniture, typically 20–30% of the construction cost.

How does Falcon Construction ensure transparent villa pricing?

Falcon provides transparent, itemized quotations before any project commitment, using structured bills of quantities. Our in-house engineering — structural, MEP, and finishing coordination under one roof — reduces change orders and protects your budget from surprises.

How long does it take to build a villa in Jeddah?

About 14 months from start to handover for a villa of 500–1,000 m², and about 16 months for 1,001–1,600 m². Design, drawings and permits add about 3 months before construction starts. These are indicative timelines, reviewed every quarter.

How long do villa design and permits take in Jeddah?

About 3 months, including design, drawings and permits. This excludes extra time if you use a specialised architectural design office, and it excludes interior work. The timing is flexible and depends on the client.

Get a Cost Estimate for Your Villa

Ready to get a real number for your villa project? Request a consultation with our team and we will walk you through a detailed cost model specific to your design and requirements.

Want to see how we build? Take a look at Falcon’s luxury villa and residential construction service.

Image showing a construction meeting.

10-Step Guide to Choosing the Best Contractor for Your Project

Whether it’s for your corporate headquarters or for your dream home, your choice of contractor can make all the difference. They may have the skills and experience. But how well do they work with their clients? Will they be able to deliver the same vision you have in your mind? Will they be their when something goes wrong?

Choosing a contractor is all about finding the perfect balance in terms of experience, price and attitude. Here are 10 steps that will help you zero in on the best contractor for your project.

  1. Have a clear vision of how you want the project to turn out.

This project is yours, so you can’t let someone else envision how this should turn out. How do you want this project to turn out? Do you prefer a Design-Build approach where you work on both the design and building with the contractor? Perhaps you have already worked out the design with an architect, but you haven’t gone through interior details and some things are subject to interpretation. Do you want a classical feel, or would you like an industrial look? Do you want a modern glossy finished doors or a stained natural wood finish? Clarify those matters to get a more accurate quote from the contractor.

Having a clear vision of how you want this to turn out will save you a lot of time in the long run. It allows you to later zero in on contractors who can share the same vision instead of imposing their own.

  1. Think about your budget.

Most of the time, property owners already have a budget in mind. However, you should leave room for adjustment. Set aside a 20% portion for the total budget for upgrades, changes, and items that you didn’t foresee. Do some research, and make some calls, so that you can set a realistic budget. The

  1. Ask for referrals.

Once you make your final decision, you’re going to have to work with this contractor over a long period of time. It’s not something you can back out from easily, especially when you start realizing that this may not be the best idea after all.

This is why it’s important to talk to people who have already experienced working with contractors in the past. Find out about their experiences so that you can set the proper expectations. Ask them for the names of contractors that they have worked with in the past and have proven to be worthy of trust.

  1. Check reviews.

Aside from the experiences of your peers and family, check reviews posted online as well. Make sure that they have considerable reviews and check for responses on any negative ones. This will help you find out about their customer service. There may be a bad review somewhere that will make you think twice about the choices you’re about to make.

  1. Look at portfolios.

Using your research and the recommendations from your peers, start checking on portfolios. Look at past projects that the names on your list have worked on in the past. There’s bound to be a few images that will reflect the kind of project you have in mind.

Check to see how diverse each contractor’s projects are. This will give you a clue on how flexible and creative they can be.

  1. Create a shortlist.

Now that you’ve seen what your different options are, it’s time to eliminate the choices that you feel do not match what you need.

Some people are wary about shortlists because they’re afraid they’ll miss out on something. Don’t worry; if you did the first few steps well, your gut feel and logic will tell you which contractors you wouldn’t want to work with. Once you have a decent shortlist, you can focus all your resources and energy into serious contractors who will most likely be able to give you the results you want.

  1. Set up meetings.

This is where the serious conversations start. Meet up with your prospective contractors and talk to them about your project. All of them will tell you that they have the experience, knowledge and capacity to work on it, but it’s up to you to read between the lines and see who will really deliver on their commitment in the end. Watch for the red-flags; if a contractor gives you a very quick quote without taking the time to study all the details of your project, they’ll hit surprises and start taking shortcuts during the project.

Talk to them about your vision and look at how they’ll respond. Will they listen to your ideas, or will they be dismissive? Some contractors will only talk about how they want the project to go without considering your thoughts. Some, however, will acknowledge your vision and will throw in a few suggestions along the way. This is the kind of collaborative work you should be looking for.

  1. Make adjustments.

After meeting up with different contractors, you’ll probably have some new elements to consider. Some contractors, for example, may tell you that some aspects of your project are unrealistic given your budget. You may also want to consider suggestions you may have been given during these meetings, especially if you feel that they would make the outcome of your project better.

  1. Do a second round of research.

Sometimes, you’ll end up with 2 or 3 choices that you feel are equally capable. When this happens, it’s time to do another round of research.

This time, dig deeper. Look at the company’s culture and find out about their processes. It’s a tough decision, especially if your final few choices are seen as the best in the field. But there will always be a few telltale signs that will show you if a certain contractor fits your needs or not.

  1. Make your final choice.

Now, it’s time to make your final choice. Using all the information you’ve gathered, you’re bound to zero in on a single contractor that you’re most comfortable with.

A handy tip if you want to make the final choice to be more subjective – you can create a point system based on the factors that matter. For example, you can grade each contractor anywhere between 1 to 5 in terms of price, experience, portfolio, etc. From there, you can easily pick the one that scores the highest.

Choosing a contractor is not just about picking the most popular one in your area. Sometimes, their vision may not fit yours. It’s also not about choosing the cheapest one, especially if the quality of their work is compromised. It’s all about finding the kind of contractor who’s going to make your vision their own and deliver a project that’s even better than what you initially imagined.

If the project you are weighing up is your own villa in Jeddah, that is the work Falcon does day to day — see how we build private villas in Jeddah.

Construction in NEOM city, Saudi Arabia

NEOM: INTO THE FUTURE

The Master Plan

The desert skyline in the north west of Saudi Arabia is set to be transformed by the construction of a giant, futuristic metropolis. Building has started on Neom, the physical manifestation of a vision that is at the cutting edge of modern technology. Life in the city promises to be a fantastic mix of sustainability and social enterprise, along with the most advanced gadgetry and conveniences. Citizens will be served by driverless cars and have entertainment at their fingertips. Artificial intelligence and automated communication systems will run a city that is built around imagination and ambition. Digital transactions will be easy and accurate, making cash unnecessary. Deliveries will drop from drones in the sky and all manner of information will be accessible to all.

Location

A colossal area of untouched land in the north west of Saudi Arabia will be used for construction. It covers 26500 square kilometers (that’s 6 times larger than Dubai) and includes territory from within the Jordanian and Egyptian borders. The city will form an independent zone with its own regulations.
Neom will effectively be built at the crossroads of the world, in a strategic location amidst one of the planet’s most significant arteries for trade. This promises to fuel massive growth and maintain a vibrant, robust economy. It will also attract professional talent from around the globe, bringing knowledge, expertise and innovation to the city.
It’s a fantastic location, both geographically and climatologically. The terrain is varied and interesting with mountains providing shelter and the Red Sea coast ensuring a cooling sea breeze. This will give the city a comfortable Mediterranean climate, making living conditions idyllic and promoting leisure and entertainment in the outdoors. Professionals who are attracted to the economic hub of Neom will also be able to find fulfilment and happiness in their home lives, ensuring a modern, sustainable society.

Energy

Perhaps the most inspiring aspect of Neom will be in its use of energy. A true smart city, it will utilize electricity for everything from transportation to entertainment and communication. Astonishingly, all of this power is set to be generated from renewable resources. This will make Neom the largest city in the world to be entirely fueled by ‘green’ energy. Enormous fields of solar panels will provide the majority of power, but wind turbines are also going to be used as well. This low-cost regenerative energy will ensure that pollution levels in the city remain incredibly low and air quality pristine. Buildings will remain clean and untainted by emissions and it will be a healthy environment for living.

Entertainment

Neom is set to redefine what urban entertainment really means. Shopping experiences will be interactive and convenient. All manner of sports will be accessible to all and technology will take entertainment to the next level, with virtual reality experiences and games around every corner. Additionally, the world’s largest garden will be constructed in the center of the city for all to enjoy.

The Ultimate Home and Destination

Neom will combine nature and technology on a scale that the world has never seen. The city will form a blueprint for urban development throughout the rest of the world. It’s this proposed mix of cutting edge innovation and abundant natural splendor that will really set Neom apart.

As Saudi Arabia’s giga-projects reshape the Kingdom, Falcon continues building for private clients too — see our luxury villa and residential construction services.

Guide to Applying Plastering onto Concrete Block Wall.

1. Gear up

Prepare your tools and materials. You’ll need a dust mask, safety glasses, and protective gloves. You obviously need sand and cement (or a pre-mix) to make the mortar. You’ll also need a mixing drill, a few buckets, and a spirit level, a long screed, a plastering hawk and a trowel.

2. Prepare the surface

Use a wire brush or industrial broom to remove any excess dust and scrap off any extra mortar coming out from the concrete blocks installation. Lightly spray the surface with water to help adhesion. As a guide to the plastering thickness, you can nail small pieces of wood at different areas of the wall.

3. Load the hawk with some mortar

Use the trowel to put a sufficient portion of mortar to work with and mix it to ensure you have a good consistency.

4. Apply the plaster (mortar) to the wall

Use the trowel to apply an even layer of plaster, starting from a top corner, going to the bottom. Work with a few blocks at a time, and try to maintain an even spread until you have covered the entire wall.

5. Screed the plastered surface

Mortar sets quickly, so once it is dry enough, apply pressure with the metal screed to achieve a smooth surface. Start from one side of the wall, keep even pressure, and work your way to the end of the wall. You’ll flatten the surface and get rid of any excess mortar.

6. Check levels and straighten the wall.

Check if the mortar is straight. A deviation of about 3 mm for every 2 meters is an accepted tolerance. Use the spirit level to remove any excess plaster if the wall level is not flat, until you achieve the desired level. Run the screed again to get a smooth surface.

7. Use the trowel for touch ups and corners.

Patch any areas that were missed using the screed, especially the corners of the wall and any areas were some irregularities in the wall existed. Smoothen the edges of the wall.

Getting the finishing details right matters on any luxury build. See how Falcon handles wall finishing and every other stage as part of our villa and residential construction service.
